A joint venture of Boskalis Nederland and Van Oord has been commissioned by the Hollands Noorderkwartier water control board to reinforce the Hondsbossche and Pettemer Sea Defense between the villages of Petten and Camperduin on the coast of the Dutch province of Noord-Holland.

Because the Hondsbossche and Pettemer Sea Defense no longer meets safety standards Boskalis is to replenish the coastline using sand. A daring design has been made in which safety is paramount but added value for the environment is also an important aspect: not just safe but also attractive and offering something for everyone. The middle section will provide space for nature while at either end, near the villages of Camperduin and Petten, the focus is on added value for recreation.

The contract

A joint venture of Boskalis Nederland and Van Oord has won a contract from the Hollands Noorderkwartier water control board to reinforce the Hondsbossche and Pettemer Sea Defense between the villages of Petten and Camperduin. The client had stipulated 'a safe design using sand with added value for nature and recreation'. Boskalis won the contract on the strength of its unique design ideas. The contract comprises the construction of the new sandy coastline and its maintenance for the next 20 years. The commissioning body for the maintenance part of the contract is the Dutch department of public works. The project, part of the second national Flood Protection Program, involves creating beaches and dunes through sand replenishment.

Work

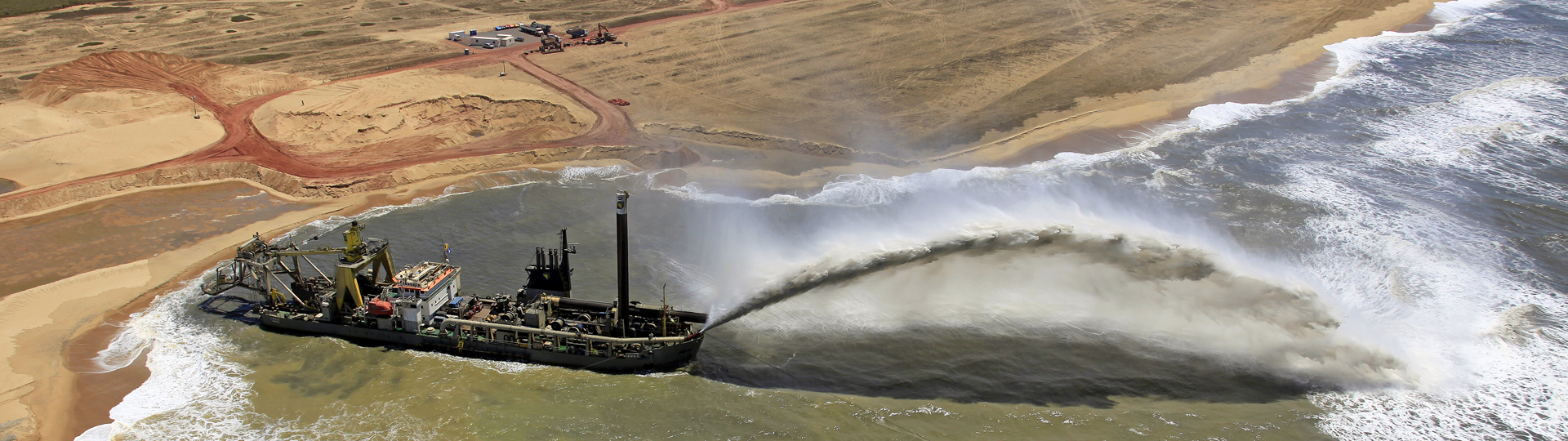

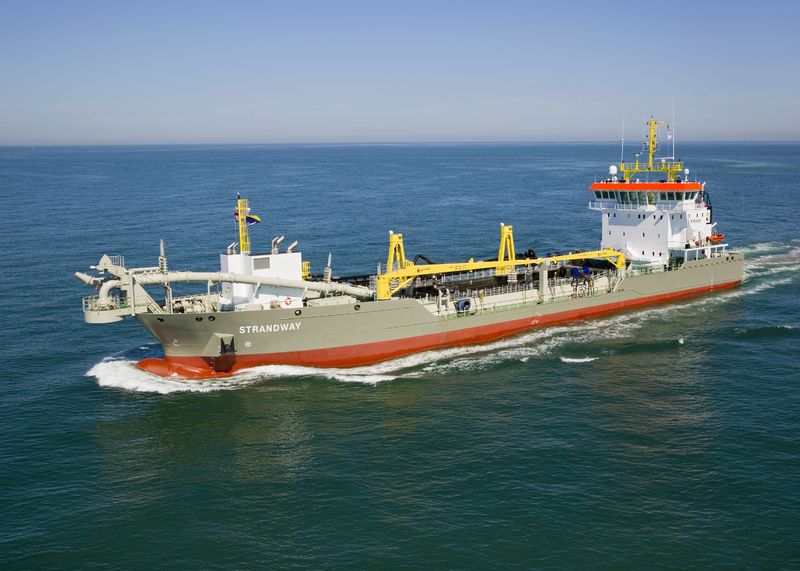

This weak link in the sea defense will be strengthened using 35 million m3 of sand from the sea, to be supplied by five trailing suction hopper dredgers: three for foreshore replenishment and two for beach replenishment. Coordination between the two large vessels has been arranged in such a way that they can unload simultaneously; the fact that the vessels do not have to wait for one another means lower fuel consumption and therefore lower carbon emissions. Replenishment of the foreshore has been going on since March 2014, with large quantities of sand having been dumped and rainbowed just off the coast. Beach replenishment work started in July and involves pumping the sand for the new beach and dunes through a 1.5 kilometers long underwater pipe. To prevent drifting the new dune will be planted with beach grass and will feature dips in the lee of the wind to allow drift sand to settle on the dune. Conversely, where drifting is desirable we are doing our best to allow for this as well.

Planning schedule

The design was announced in December 2013 and execution of the project started in early 2014. The safety of our coastline must be back up to standard by 31 December 2015. After the sand is in place the joint venture will still be busy in early 2016 realizing cycle tracks, footpaths and bridleways, and creating beach access points as well as several unique features such as the panoramic dune and the beach lagoon. After completion the joint venture of Van Oord and Boskalis Nederland will be responsible for the maintenance for a period of 20 years.

Related projects

Selected filters

P67 FPSO Transportation

On behalf of Company Petrobras and Client COOEC, Boskalis executed the dry transportation of the P-67 FPSO in 2018 from the COOEC Qingdao yard in China to Rio de Janeiro in Brazil. The P-67 FPSO will produce 150,000 bpd and compress six million cubic meters of natural gas daily in the Lula North section of the Lula-Cernambi field in the Santos basin.


Artificial island
off the coast of
Jakarta, Indonesia

Boskalis has been awarded a contract by PT Muara Wisesa Samudra to design and construct an artificial island measuring 160 hectares off the coast of Jakarta, Indonesia. The work is part of the dredging and land development works for the new Pluit City. It will be executed in a joint venture with Van Oord.


Redevelopment Waterfront, Harderwijk

Boskalis Nederland is involved in one of the largest redevelopment projects in the Netherlands. The Harderwijk Waterfront project involves the complete transformation of the lakeside area of this IJsselmeer town. The project covers a strip approximately six kilometers long, combining homes, work and recreation in a natural way. The Harderwijk Waterfront will generate a quality boost in many areas: quality of life, employment, traffic, tourism and the environment.


Road enlargement motorway A1-A6, Diemen-Almere

The A1/A6 project is one of the five sub-projects for Rijkswaterstaat that are included in the upgrading of the road network linking Schiphol Airport, Amsterdam, and Almere (SAA). The total length of the SAA link is 40 kilometers. Boskalis, together with partners, is responsible for the section from the Diemen intersection to Almere, a distance of approximately 23 kilometers.


Port maintenance,
Açu Port

Açu Port in São João da Barra, Rio de Janeiro (Brazil) is one of the largest port-industry complex in Latin America. The port consists of two terminals: T1, an offshore terminal for handling iron ore and oil, and T2, an onshore terminal built around the inner navigation channel which accommodates offshore supply companies and will handle bauxite, general cargo and vehicles.

Shell Malikai

Malikai is a deepwater oil discovery in offshore Sabah, Malaysia where Sabah Shell Petroleum Company is the designated Operator. A floating Dry Tree Unit (DTU) will be installed over Malikai field utilizing a Tension Leg Platform (TLP) design that suits the Malikai environment.
